Are You Facing These Project Challenges?

📋 You want to start a granulation project, but have no idea how long the whole process will take?

From contract signing to commercial operation – how many steps are involved? How long does each step take? No one has given you a clear roadmap.

💰 Your budget always overruns, and you don’t know where the money actually goes?

Equipment quotes are just the tip of the iceberg. Civil works, installation, environmental assessment, training, spare parts, energy consumption – which costs are mandatory, and where can you optimize?

⚠️ You are most afraid of problems halfway through the project, with no one taking responsibility?

Equipment arrives but cannot be installed, workers do not know how to operate, the production line does not run smoothly – with multiple parties coordinating and shifting blame, the project stalls for months.

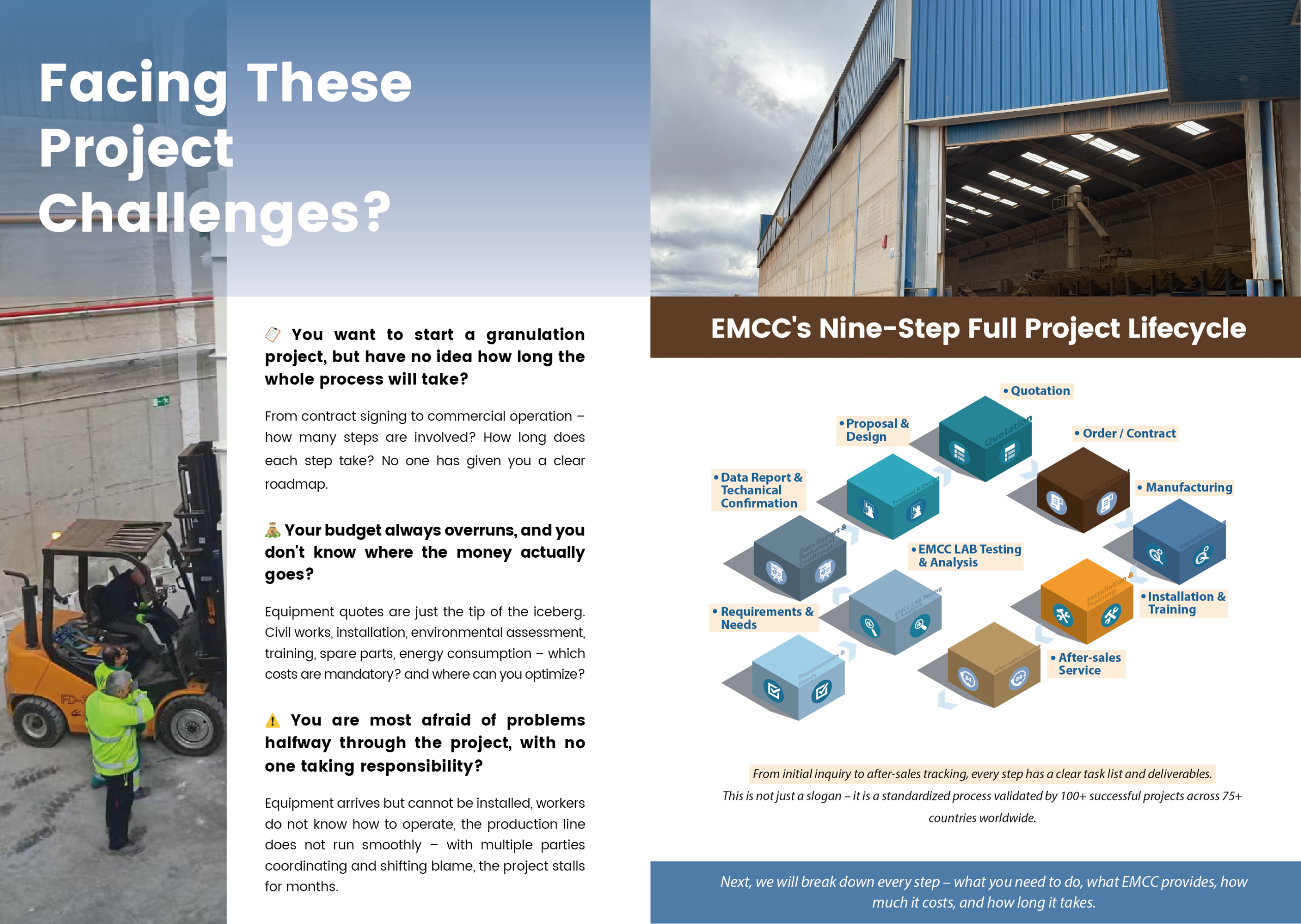

EMCC’s Nine-Step Full Project Lifecycle

Requirements & Needs → EMCC LAB Testing & Analysis → Data Report & Techanical Confirmation → Proposal & Design → Quotation → Order / Contract → Manufacturing → Installation, Commissioning & Training → After-sales Service

From initial inquiry to after-sales tracking, every step has a clear task list and deliverables.

This is not just a slogan – it is a standardized process validated by 100+ successful projects across 75+ countries worldwide.
